How Long Does a Bathroom Remodel Take in Central Indiana?

how long does a bathroom remodel take central indiana

Bathroom remodel timelines depend on scope, layout changes, permits, and what we find once the room is opened up.

Quick Answer: Most bathroom remodels take about 2 to 6 weeks of on-site work, but the full timeline can stretch longer when planning, product ordering, permit review, and hidden issues are part of the job. A simple refresh moves faster. A full remodel with tile work, plumbing changes, or repairs for older homes takes more time.

TLDR

  • Most bathroom remodels take about 2 to 6 weeks of active construction, depending on the scope.
  • A cosmetic refresh often moves faster than a full remodel with tile, plumbing, or layout work.
  • Permit review can delay construction in Lafayette, West Lafayette, and nearby areas.
  • Older homes can slow a project when hidden water damage, framing issues, or outdated plumbing show up.
  • Custom tile showers and special-order materials often add time to the schedule.
  • The cleanest way to avoid delays is to finalize selections and scope before demolition starts.
  • If you want a clear schedule tied to your actual bathroom, request a quote from Starling Construction.

One of the first questions homeowners ask is how long the bathroom will be out of commission, and that is fair. This is one of the hardest-working rooms in the house. If the answer is vague, the whole project feels harder to trust.

At Starling Construction, we plan bathroom remodels around real scope, real materials, and real jobsite conditions in Central Indiana. That means we do not throw out a fantasy calendar to make the sales process feel easier. We give you a schedule that makes sense for your home, your priorities, and the work involved.

If you want to talk through your bathroom goals now, request a quote, and we will help you map out the likely timeline for your space.

Why Bathroom Remodel Timelines Vary So Much

A bathroom is a small room, but it packs in a lot of moving parts. Demolition, framing, plumbing, electrical, waterproofing, flooring, tile, trim, paint, glass, and fixtures all have to line up in the right order. The more custom the work gets, the more the calendar depends on details.

Scope is one of the biggest drivers of timing. If the layout stays the same and the work focuses on replacing finishes and fixtures, the job usually moves faster. When the project includes expanding the shower, relocating plumbing, modifying walls, or correcting hidden damage, the timeline lengthens because the work becomes more extensive and requires greater coordination among trades.

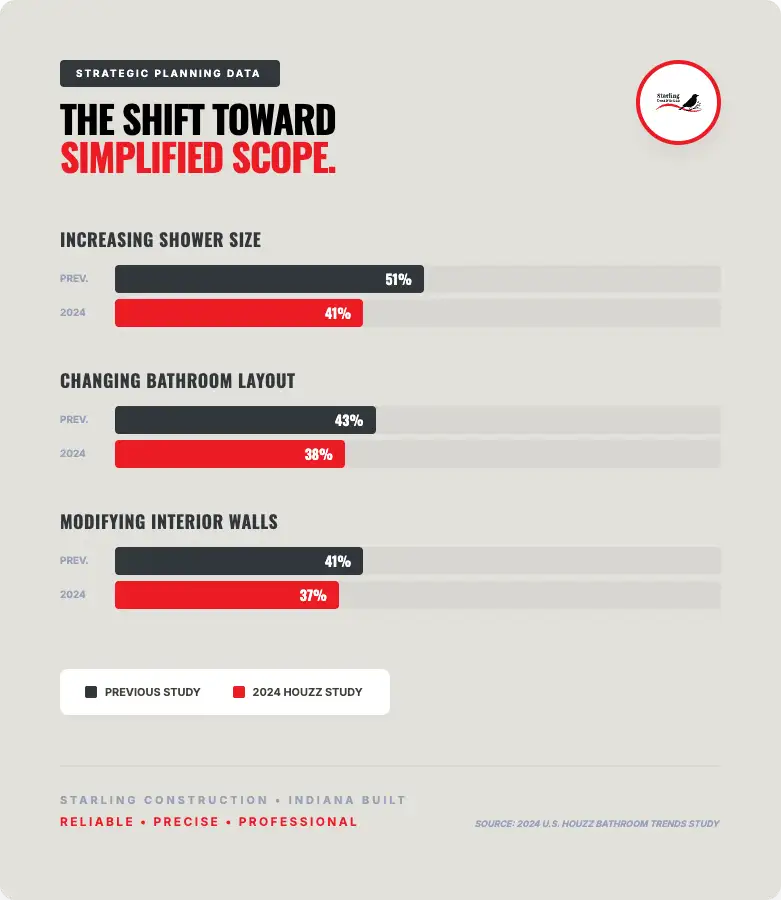

bathroom remodel trends simplified scope houzz study

That lines up with what homeowners across the country are doing. In the 2024 U.S. Houzz Bathroom Trends Study, changing the layout dropped from 43% to 38%, and increasing shower size dropped from 51% to 41%. In plain English, fewer people are taking on the bigger, slower changes unless they really need to. According to the 2024 Houzz Bathroom Trends Study, scope decisions still shape the entire project, from the timeline to the cost.

A Real Bathroom Remodel Timeline by Project Type

Project TypeTypical On-Site TimelineWhat It Usually Includes
Cosmetic Bathroom RefreshAbout 1 to 2 weeksPaint, vanity swap, lighting, fixtures, minor finish updates, and limited flooring
Standard Full Bathroom RemodelAbout 2 to 4 weeksNew flooring, vanity, toilet, tile, fixtures, finish work, same basic layout
Full Remodel With Custom Shower or Layout ChangesAbout 4 to 6 plus weeksCustom tile shower, plumbing changes, waterproofing, framing, electrical updates, and inspections
Older Home Bathroom Remodel With RepairsVariesSubfloor repair, framing correction, plumbing updates, moisture damage, and lead safe work practices when applicable.

Those ranges are not one-size-fits-all. They are the practical ranges homeowners should expect when the work is planned properly, and the contractor accounts for real conditions rather than selling a dream and fixing it later.

What Happens Before Demo Starts

Construction is only part of the full bathroom remodel timeline. Before the demo starts, there is usually a planning phase that matters more than homeowners realize. This is where a smooth job gets set up, or where a messy one quietly starts falling apart.

  • Initial walkthrough and scope discussion
  • Measurements and layout review
  • Material and finish selections
  • Quote approval and scheduling
  • Permit planning if required
  • Product ordering and delivery coordination

That planning-first approach fits the way Starling already works. The bathroom remodeling service page promises clear communication, straightforward pricing, and a timeline that makes sense for the household, rather than a vague promise that gets fuzzy once the walls come down. See how Starling approaches bathroom remodeling here.

How Local Permits Can Affect the Timeline in Lafayette, West Lafayette, and Frankfort

Permit timing is one reason a remodel can take longer than the number of days a crew is physically in the room. Some jobs stay cosmetic. Others trigger permit review because structural, electrical, or plumbing work is involved.

In Lafayette, residential permit reviews may take up to 7 days once the submission is complete. In West Lafayette, the building department says permit review takes 10 business days once all required information is submitted. According to the City of Lafayette building permit page, residential review may take up to 7 days. According to West Lafayette permit guidance, permit review takes 10 business days, and remodel permits are needed when structural work is involved.

lafayette west lafayette permitting review timelines

That does not mean every bathroom remodel gets delayed by permits. It means homeowners should separate two ideas: how long the work takes on-site and how long the full project takes from approval to completion.

What Usually Slows a Bathroom Remodel Down

Most delays stem from a short list of recurring issues. None of them is exotic. They are just the parts of remodeling that punish weak planning.

Delay FactorWhy It Adds Time
Layout changesMoving plumbing, walls, or fixtures increases coordination and inspection needs.
Custom tile showersPrep, waterproofing, tile setting, cure times, and glass coordination add steps.
Special order materialsVanities, fixtures, lighting, and glass can push the schedule if they arrive late.
Water damage or subfloor issuesHidden repairs have to be corrected before the finish work can continue
Older plumbing or wiringOutdated systems often need correction once the wall or floor is opened
Late design decisionsWaiting on tile, hardware, or layout changes can stall the entire sequence

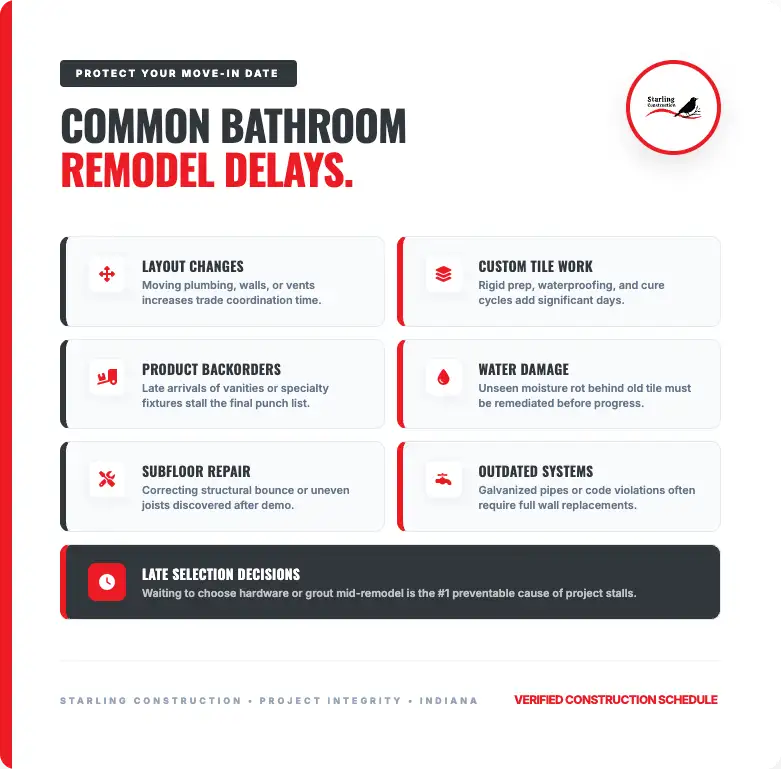

common bathroom remodel delays infographic

Older Homes: Why Hidden Conditions Matter

Central Indiana homes can surprise you after demolition starts. Uneven floors, patched plumbing, moisture damage, and older framing details are common reasons why a simple bathroom plan becomes more involved. That is not the contractor being dramatic. That is remodeling in real houses.

Older homes can also bring lead safety considerations into play. EPA guidance on renovation work in pre-1978 homes explains that disturbing lead-based paint can create hazardous dust and that lead-safe work practices are required for covered jobs. That does not mean every older bathroom remodel becomes a major regulatory event, but it does mean older homes deserve more caution and more realistic scheduling.

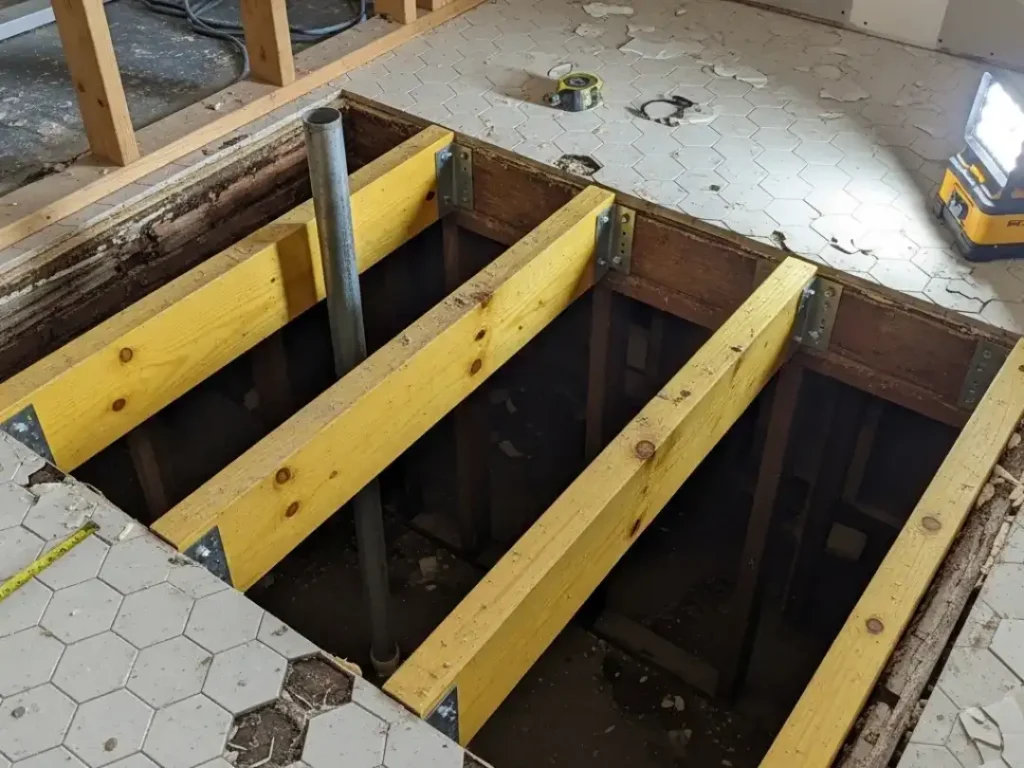

bathroom remodel floor joist structural repair

This is one reason experienced bathroom remodelers plan for uncertainty rather than pretend it does not exist. NARI’s Certified Kitchen and Bath Remodeler standards specifically call out jobsite assessment, hidden conditions, trade expertise, and layout knowledge as part of competent bathroom remodeling work.

How to Keep Your Bathroom Remodel on Schedule

Homeowners have more control over the schedule than they think. A few decisions up front can save a lot of friction once the project starts.

  • Finalize tile, fixtures, vanity, lighting, and hardware before demo
  • Keep the layout if the current footprint already works well enough
  • Ask for a written scope and a clear sequence of work
  • Avoid mid-project changes unless they solve a real problem
  • Have a backup bathroom plan if this is your main bath
  • Choose a contractor who communicates clearly and flags problems early

That last point matters more than most people want to admit. Homeowners naturally ask when the project will start, when it will finish, and how much it will cost. NARI’s homeowner guide says those questions matter, but they should not be the only questions. The process behind the answer matters too.

What to Expect During Construction Week by Week

Every remodel is different, but a standard bathroom remodel often follows a sequence like this:

  1. Week 1: Site protection, demolition, haul off, framing adjustments, rough plumbing, and electrical review
  2. Week 2: Rough plumbing and electrical work, inspections if needed, prep for wall and floor assemblies
  3. Week 3: Waterproofing, shower prep, tile installation, subfloor correction, or finish floor prep
  4. Week 4: Vanity, toilet, trim, paint, lighting, plumbing fixture installation, punch list work
  5. Week 5 and beyond, if needed: Custom glass, specialty finishes, repair work found after demo, final details, and walkthrough

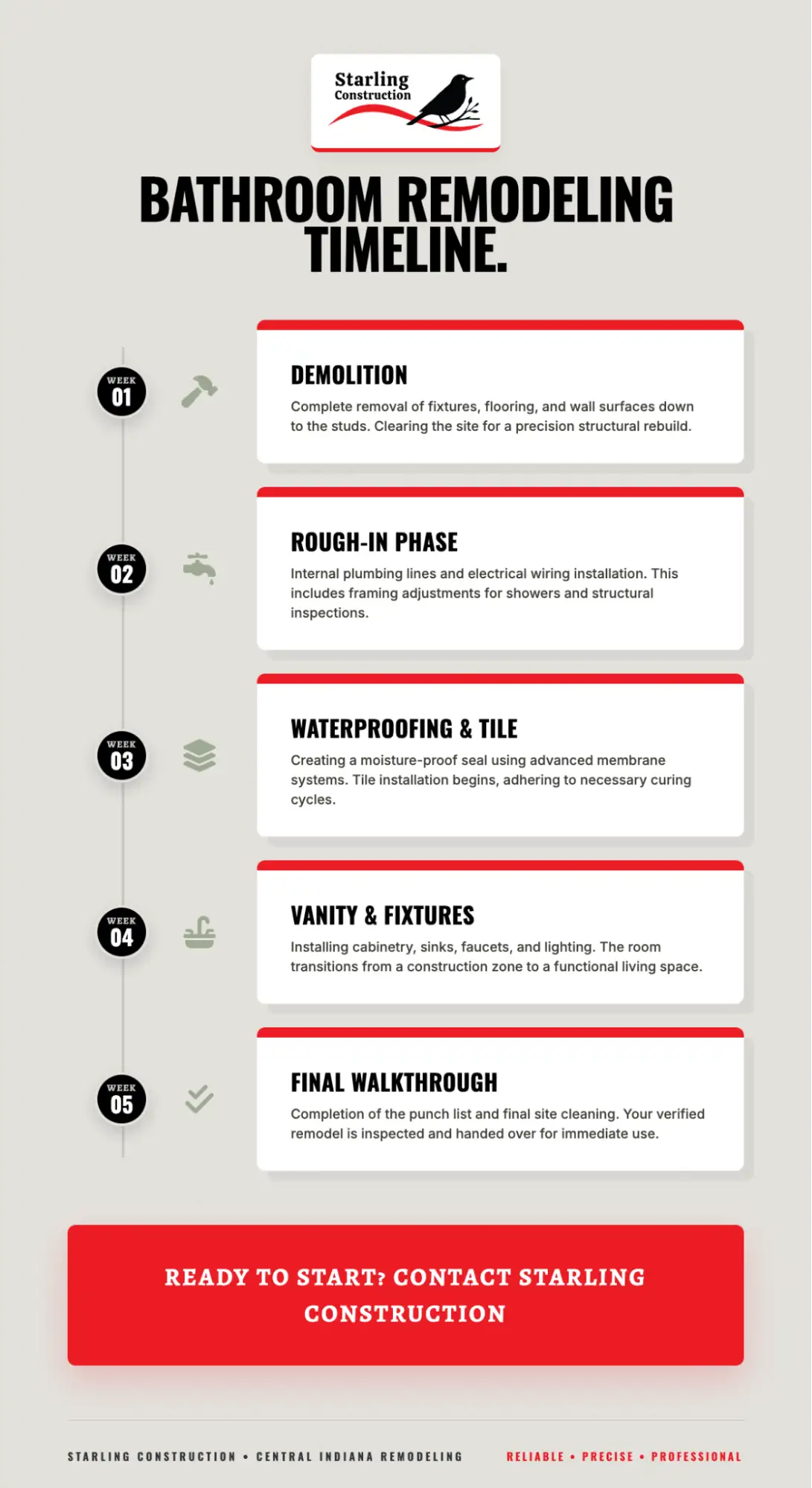

bathroom remodeling timeline starling construction

Need a Bathroom Remodel Timeline Based on Your Actual Space?

If you want a clear next step, request your bathroom remodeling quote. We will review your layout, goals, and the level of work involved so you can move forward with a schedule that makes sense.
